BASIC PROJECT DATA
Project ID: PA1A021
NEED AND ADDED VALUE FOR THE DANUBE REGION STRATEGY
Critical sections on the Danube River in Serbia are identified in the Master Plan for IWW Transport in Serbia (2006). On those sections fairway parameters are not established in accordance with Danube Commission Recommendations. River training works are needed in order to achieve fairway parameters which would improve navigation conditions in terms of safety. The elimination of critical sections will contribute to the improvement of mobility on the Danube River and the entire Pan-European Transport Corridor VII.
OBJECTIVE(S) OF THE PROJECT
Necessary designs and tender documentation for river training works on six critical sections on the Danube River in Serbia were elaborated, in order to start river training works and improve navigation safety conditions.
CONDUCTED PROJECT ACTIVITIES
- Preparation of Pre-feasibility study and general designs for all critical sectors on the Danube River from Bezdan to Belgrade
- Preparation of Feasibility study and conceptual designs for all critical sectors on the Danube River from Backa Palanka to Belgrade
- Preparation of EIA Study
- Preparation of main designs and tender documentation for six selected critical sectors on the Danube River from Backa Palanka to Belgrade
- Construction permit
TRANSBOUNDARY IMPACT
The project was focused on the stretch of the Danube River between Backa Palanka and Belgrade, not targeting the joint stretch of the river.
Some critical sectors are located at the Serbian-Croatian joint stretch of the Danube river. Cooperation between the two administrations is needed regarding environmental impact in cross-border areas (both countries signed the ESPO convention). Cooperation is also needed in terms of achieving common technical solutions for designs for critical sections located in the joint section.
This cooperation will be executed within the Commission for implementation of Serbian-Croatian Bilateral Agreement on Navigation (signed in 2009).
PROJECT BENEFICIARIES / TARGET GROUPS
Main beneficiaries of the project are the Ministry of Construction, Transport and Infrastructure, and MCTI – Directorate for Inland Waterways (Plovput).
STATUS AND TIMEFRAME
Start date: 13.05.2011
End date: 01.11.2014
The project is already concluded.
FINANCING
Total budget: 2,200,000 EUR
EU funds: 2,200,000 EUR were funded by Instrument for Pre-Accession Assistance (IPA) – National Programme 2010
PROJECT TEAM
Project leader: Witteveen+Bos / The Netherlands
(website: http://www.witteveenbos.nl/)
Organisation: Directorate for Inland Waterways – PLOVPUT (website: www.plovput.rs)
Address: Francuska 9; 11000 Belgrade / Republic of Serbia
Project partner(s):
- Energoprojekt (Serbia)
- DHI (Denmark)
PROJECT ENVIRONMENT
PROJECT CROSS – REFERENCE
Follow-up project: River Training and Dredging Works on Critical Sectors on the Danube River & Supervision and Environmental Monitoring of River Training and Dredging Works on Critical Sectors on the Danube River (PA1A129)
STRATEGIC REFERENCE
- Master Plan for IWW Transport in Serbia (2006)
- Serbian Transport Development Strategy for Period 2008-1015 (2008)
- General Master Plan for Transport in Serbia (2009)
RELEVANT LEGISLATION
- Serbian Law on Navigation and Orts on Inland Waterways (2010, 2012)
- Serbian Law on Environmental Impact Assessment
- Serbian Law on Spatial Planning and Construction
- Danube Commission Recommendations
- AGN (UNECE)
OTHER
In the Master Plan for IWW Transport in Serbia (2006) priority projects are identified, among them river training works on critical sections on the Danube River. The preparation of this document was funded by the EU.

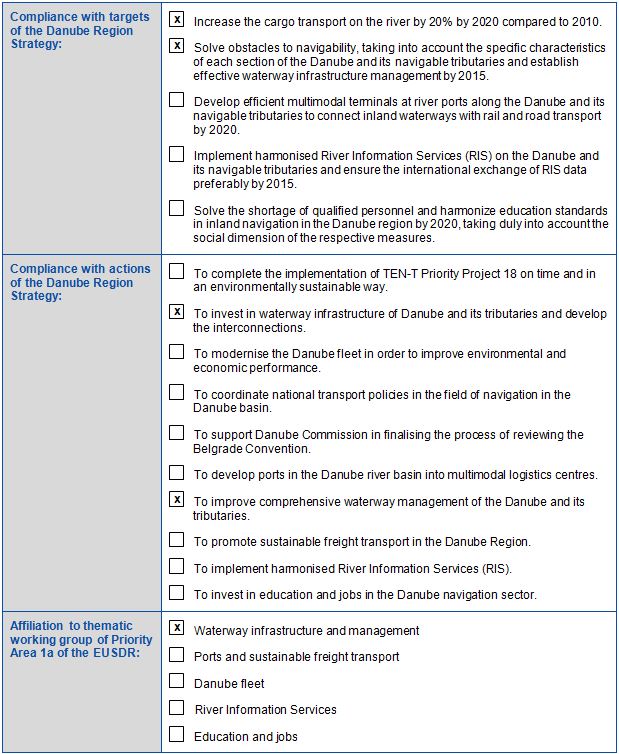

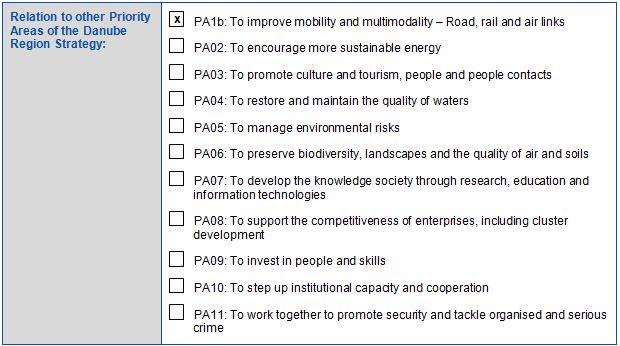

EUSDR EMBEDDING
EUSDR COMPLIANCE
OTHER RELEVANT ISSUES
PROJECT REQUIREMENTS
Collection of relevant hydrographic surveying data together with hydrological data was needed, in order to prepare hydraulic model. All data was collected and hydraulic and morphological models were prepared, as well as alternative options and conceptual designs for 6 critical sectors between Backa Palanka and Belgrade.
FOLLOW – UP PROJECT
The follow-up project is currently being implemented (see Project Environment above). It will entail the execution of River Training Works on six critical locations for which main designs and tender documentation were prepared. Objective of the project is the elimination of critical sections, which will contribute to the improvement of mobility on the Danube River. The value of this project is about EUR 14,100,000 (including contracts for works and contract for supervision and environmental monitoring). Source of funding is the EU IPA 2013 programme.
META DATA
Data provided by: Ivan Mitrovic (Plovput, Republic of Serbia) – 12.09.2011
Last update by: Ivan Mitrovic (Plovput, Republic of Serbia) – 06.02.2017
